If you've ever opened a crate and found a long plastic part that left China flat and arrived bent, you already know the drawing wasn't the problem. Long plastic part warping rarely shows up at the machine. It shows up 24 to 72 hours later, on the inspection bench or the assembly jig. By then, the part is already on a container ship.
Two mechanisms drive most field failures on parts over 600 mm:
Extruded and cast billets carry locked-in cooling stress. Cut one face without balancing the other, and the billet relaxes into a curve once it leaves the fixture. Semi-crystalline grades like POM and PEEK keep moving for one to three days after the final pass.
POM, PEEK and HDPE conduct heat at 0.2–0.4 W/m·K — far below any metal. Cutting heat stays inside the part, softens the polymer, and re-freezes new stress into the geometry as it cools. Standard vises and hard jaws then elastically deflect the soft polymer; the part reads in-spec on the CMM and springs back hours later.
Most shops run plastic on aluminum parameters — same feeds, same fixtures, same single-pass roughing. That habit is behind most field reports of overnight warping on long plastic parts.

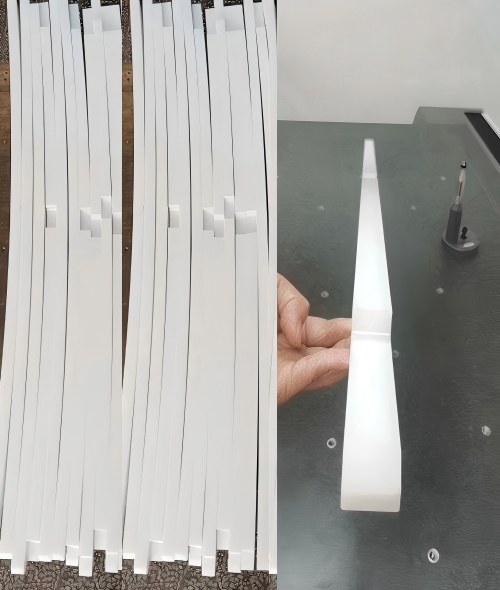

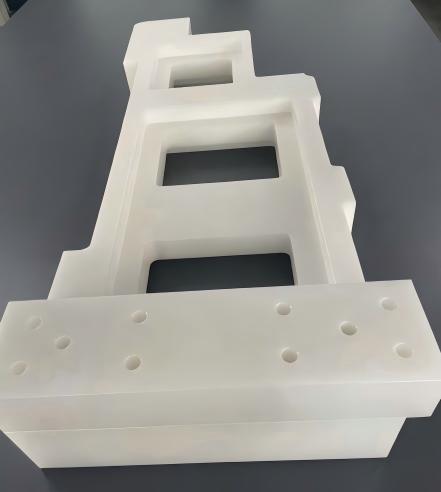

So how to prevent plastic warping in CNC work on parts over a meter? It takes a process built around the polymer, not the spindle. Two recent jobs — a 110 cm HDPE channel and a 125 cm POM frame — landed on our floor for exactly this reason. See how we held them flat ↓
When long plastic part machining fails, it rarely fails on the machine. It fails 24 hours after the part leaves the shop. Both jobs below arrived warped from a prior process, and both are now in repeat production with us.

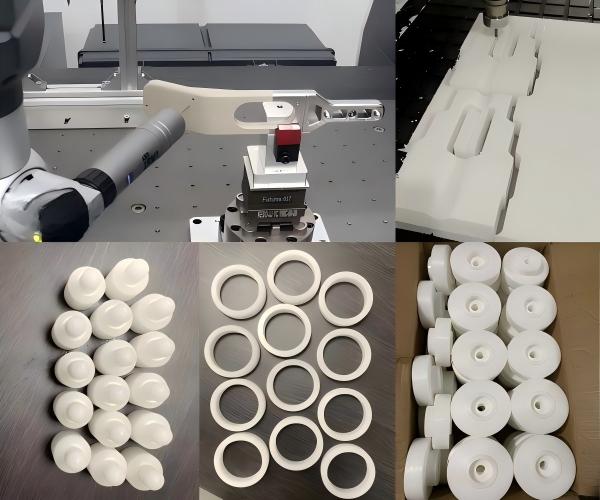

Under 300 mm, residual stress hides inside the geometry. Past 800 mm, anneal cycle, pass depth, clamp strategy, and operation order decide whether the part survives the freight container — not whether it passes first-article CMM. The five engineering controls behind both cases, and the one shop-floor decision most suppliers don't disclose, are next. ↓

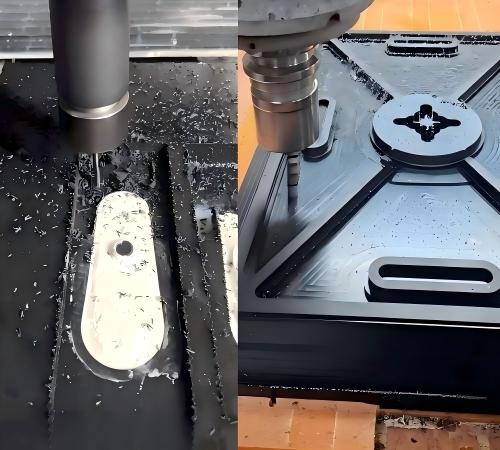

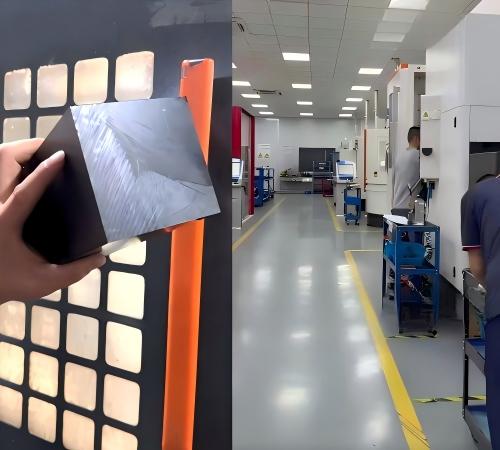

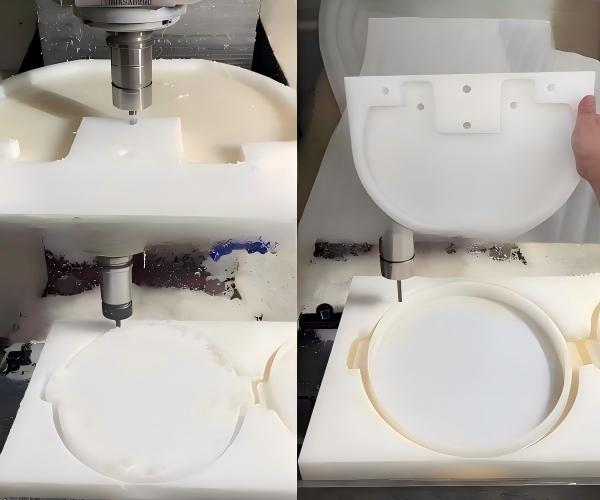

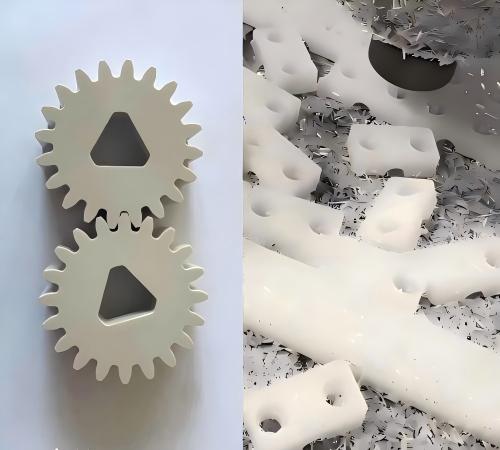

The parts above didn't hold shape by luck. Every long plastic job runs through the same five-control protocol — each targeting a specific failure mode we've documented over two decades.
Five controls solve the geometry. Next decision: which polymer, and what tolerance it can actually hold. ↓
Skip the technical details — upload your STP and get a feasibility note in 24 hours →Ten engineering plastics run through our precision plastic machining cell in production volume. The table below is what our engineers quote against — not a marketing range.
| Material | Key Property | Std Tol | Tightest Tol | Typical Use |
|---|---|---|---|---|
| POM / Delrin / Acetal | Low friction, dimensional stability | ±0.1 mm | ±0.05 mm | Robotics gears, food rollers |
| PEEK | 260 °C service temp, chemical resistant | ±0.1 mm | ±0.05 mm | Aerospace bushings, semicon carriers |
| PTFE / Teflon | Chemically inert, low friction | ±0.2 mm | ±0.13 mm | Chemical seals, valve seats |
| HDPE | FDA-compatible, impact resistant | ±0.15 mm | ±0.1 mm | Food-line guides, scrapers |
| PP | Chemical resistant, weldable | ±0.15 mm | ±0.1 mm | Chemical tanks, lab fittings |
| ABS | Tough, paintable | ±0.15 mm | ±0.1 mm | Enclosures, jigs |
| PC | Transparent, impact resistant | ±0.1 mm | ±0.05 mm | Light covers, machine guards |
| Nylon (PA6/PA66) | Wear resistant, tough | ±0.15 mm | ±0.1 mm | Bushings, bearings, gears |
| UHMW | Highest abrasion resistance | ±0.2 mm | ±0.15 mm | Wear strips, chain guides |
| PMMA | Optical clarity | ±0.1 mm | ±0.05 mm | Optical windows, displays |
Minimum wall 0.5 mm · minimum hole Ø1.0 mm · max length 1,500 mm · DIN ISO 2768-m by default.
POM releases trace formaldehyde under cutting heat. Every spindle in our plastic cell runs local dust extraction to keep operator exposure and part contamination under control. Recent run: 320 pcs of robotics cam followers at ±0.05 mm.

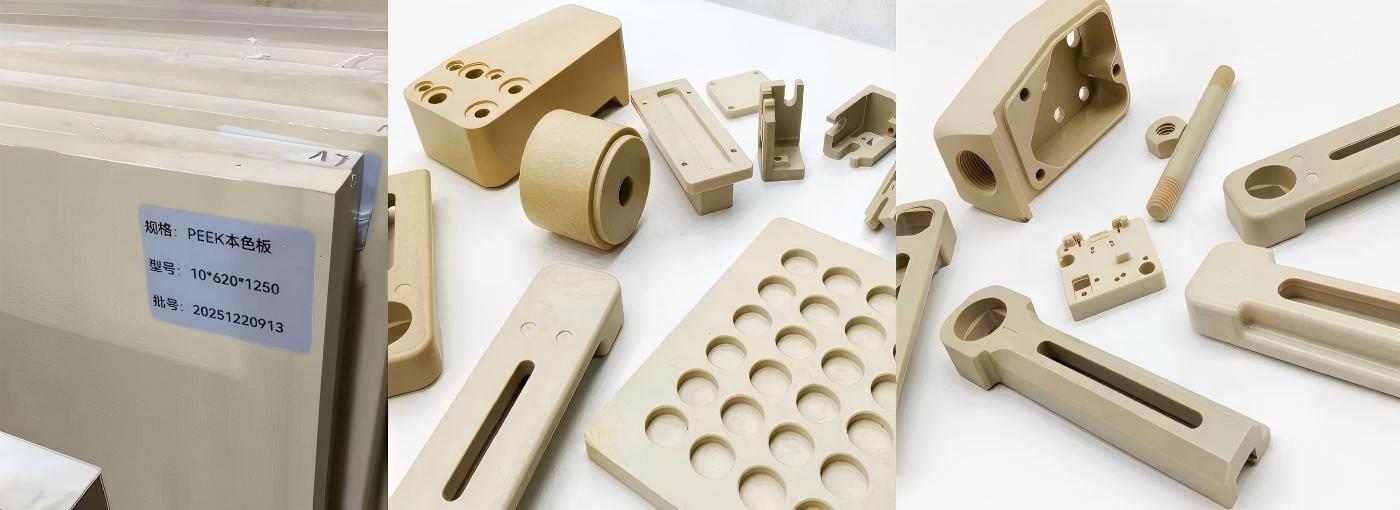

PEEK is the most expensive engineering plastic we cut — stock cost alone can exceed $200/kg, and scrap from a wrong feed rate is unrecoverable. We run diamond-coated tooling, dry-machine where possible to avoid stress cracks, and dedicate a first-article inspection on every PEEK job before continuing the batch. Carbon-filled (CF30) and glass-filled (GF30) PEEK grades available on request.
PTFE deflects elastically under tool pressure — the cutter pushes the material aside instead of removing it, throwing dimensions off. We compensate with sharp single-flute tools, very light depth of cut, and controlled chip evacuation rather than aggressive deburring. For thin-walled cantilever features under 0.5 mm across spans over 80 mm, we flag the deflection risk in the feasibility report and discuss a fillet or stiffening rib with your engineer before quoting — the part still runs, it just runs better with a 0.3 mm design tweak.
HDPE expands ~0.2 mm per 100 mm across a 30 °C swing. Long stock is conditioned to shop temperature for 24 hours before finishing cuts — a step most shops skip.
Polypropylene machining demands tool swaps at roughly half the interval used for harder plastics. PP softens easily under friction and welds back onto the cutting edge within minutes, which is the most common cause of dimensional drift in shops new to the material.
PC requires post-drill annealing around holes to prevent stress cracks. Nylon must be oven-dried before cutting — it absorbs ~2% ambient moisture, enough to throw a tight bore. PMMA windows are finished by flame or vapor polishing. ABS holds paint well for branded enclosures. UHMW is reserved for high-abrasion wear strips where dimensional tightness is secondary.
Use this matrix when choosing the best plastics for CNC machining against load, environment, and budget. Performance columns: ★★★★★= strongest. Cost column: $ = lowest, $$$$$ = highest.
| Property | POM | PEEK | PTFE | HDPE | PP | Nylon |
|---|---|---|---|---|---|---|
| Strength | ★★★★☆ | ★★★★★ | ★★☆☆☆ | ★★★☆☆ | ★★☆☆☆ | ★★★★☆ |
| Temp Resistance | ★★★☆☆ | ★★★★★ | ★★★★★ | ★★☆☆☆ | ★★★☆☆ | ★★★☆☆ |
| Chemical Resistance | ★★★☆☆ | ★★★★☆ | ★★★★★ | ★★★★★ | ★★★★☆ | ★★★☆☆ |
| Machinability | ★★★★★ | ★★☆☆☆ | ★★☆☆☆ | ★★★★☆ | ★★★★☆ | ★★★☆☆ |
| Cost | $$ | $$$$$ | $$$ | $ | $ | $$ |
That feasibility report lands in your inbox within 24 hours of file upload. Here's the six-step path it kicks off →
From STP upload to delivery, every job runs the same documented workflow. No black box, no revised invoices after the chips start flying.
This is the CNC plastic machining process behind every order. A part held to drawing means little if the surface finish fights the way it will be assembled — and that decision is more nuanced than most spec sheets suggest. ↓
Most engineers ordering machined plastic parts don't actually want a "finished" surface — they want a surface that assembles cleanly, seats predictably, and doesn't shift dimensions in post-processing. That's why our standard finish is built around what your part needs to function, not what looks good in a photo.

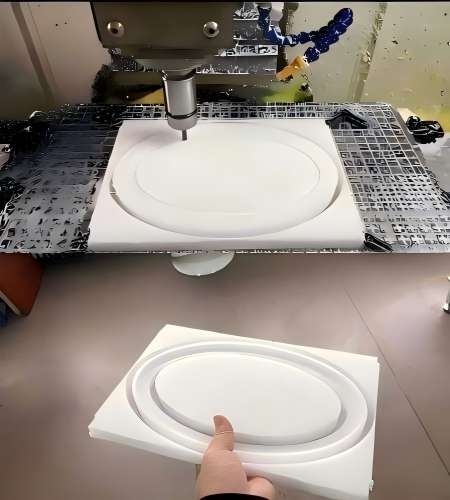

Every part leaves our floor with manual deburring and edge-breaking on machined edges and through-holes. Tool marks on primary surfaces are preserved intentionally. Here's why that matters: secondary polishing on POM, PEEK, and PTFE removes 0.02–0.08 mm of stock and can shift bore concentricity or flatness on parts you've already signed off via CMM. If your drawing calls a Ra range, we hold it through machining strategy — not through downstream sanding.

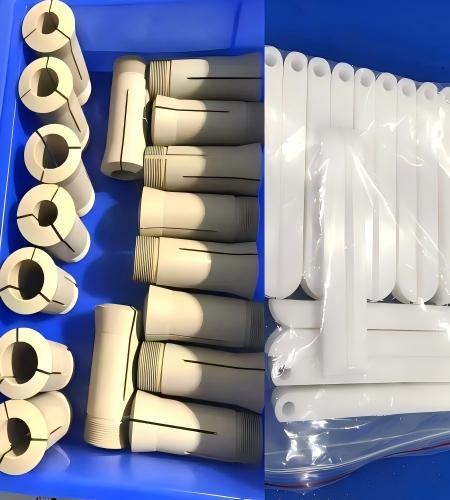

For soft polymers (HDPE, UHMW, PP), we use chilled deburring on thin edges to avoid the smearing that warm blades cause on cantilevered features.
Each optional process is quoted as a separate line item. No bundled "premium finish" upcharge, no surprises on the invoice.
The answer to which finish you need depends less on the material than on where the machined plastic parts end up — food line, robot end-effector, or chemical valve seat. The four industries below show how we tune fixturing and inspection for each. ↓
Four sectors account for most of the machined plastic parts we ship. Each has its own failure mode — and each shapes how we quote, fixture, and inspect.
| Industry | Typical Parts | Default Materials | What We Watch For |
|---|---|---|---|
| Food Packaging Machinery | Conveyor guides, scrapers, U-channel rails, chain guides | HDPE (FDA), UHMW, PP | Lot-traceable material certs; CIP washdown stability at 70–85 °C; moisture absorption before ship |
| Automotive | Interior brackets, sensor housings, under-hood clips, fixture jigs | ABS, PC, glass-filled Nylon, POM | PCD tooling on GF-Nylon to prevent fiber pull-out; polished carbide on PC/ABS for visible surfaces |
| Industrial Automation & Robotics | End-effector components, cam followers, linear guide blocks, vacuum cup backings | POM, PEEK, Nylon | Sub-±0.05 mm on mating features; batch sizes 20–500 with repeat-order consistency |
| Chemical Processing | Valve seats, pump components, gasket backings, corrosion-resistant fittings | PTFE, PP, PVDF | Media list (concentration, temperature, exposure cycle) reviewed against manufacturer compatibility data before quoting |
If your part doesn't sit neatly in one row, it usually still fits our envelope. The harder question is which kind of machined plastic parts manufacturer you actually need — a platform broker, a local shop, or a dedicated plastics specialist. That comparison is next. ↓
Picking a custom plastic parts manufacturer usually means trading one thing off against another — speed against cost, cost against engineering depth, depth against communication. Below is how KTM lines up against the three options most of our clients shortlisted before they sent us their first STP.
| Dimension | Xometry-type Platform | US Local Shop | Other China Shop | KTM |
|---|---|---|---|---|
| Who actually cuts your part | Outsourced to a partner network | Local crew under one roof | Quoted by one team, machined by another | Our own Dongguan floor, machined by named operators |
| Engineer access | Routed through a sales rep | Direct, within business hours | Sales rep relay; time-zone clarifications add 1–2 days | Direct chat with the engineer who reviewed your file |
| Pricing model | Algorithm-driven, US labor rate | Highest baseline | Lowest headline; final invoice may shift from quoted figure | Fixed quote — written, locked, delivered |
| Plastic focus | Generalist, mixed metal + plastic queue | Mixed workload | Mixed workload | Dedicated plastic workflow, separate from metal |
| Revision turnaround | 3–5 days via portal ticket | 1–2 days | 2–4 days | Same business day on most DFM callouts |
| Documentation included | Basic dimensional report | Varies by shop | Often missing on first run | Inspection report, photo report, packing details |
We don't put this table here to win you over. We put it here so you can sanity-check any quote — including ours — against the four trade-offs every plastic CNC job hides: who cuts it, who answers your email, what the invoice actually says, and what arrives on the dock.
Our founder graduated in Mechanical Mold Design, spent two decades on the shop floor, and still personally reviews every feasibility report before a quote leaves the building. That single habit is the reason a custom plastic parts manufacturer and plastic CNC machine shop based 12,000 km from your factory can still respond faster than a platform partner two clicks away.
Currently shipping to engineers in 12+ countries — US, Germany, UK, France, Mexico, Poland and more. Send the part. An engineer opens the file, writes the feasibility note, and signs the quote — no sales relay, no platform middleman.
If the geometry or quantity isn't a fit for CNC, we'll say so in plain language and point you toward molding, vacuum casting, 3D printing, or a redesign path. An honest answer in a day is worth more than a wrong quote in an hour. Your files sit on an access-controlled server and are deleted on request once the project closes.
